Mesa Pool Construction
Every step of a new pool build in Mesa, from the design visit and City permit to the first fill.
A new pool is built in a set order, and each stage has to pass before the next begins. Knowing the sequence helps you plan around the noise, the open dig and the days with a truck in front of the house.
Before anything is dug, we request Arizona 811 utility locates and confirm the access route into the backyard. On many Mesa lots that means temporarily opening a section of the side or rear block wall.
City of Mesa inspectors work Monday through Friday, 6:30 a.m. to 5 p.m., and inspections can be booked online, by phone or by text. The City wants a printed set of the approved plans on site for every visit, and a permit stays valid for 180 days after it's issued.

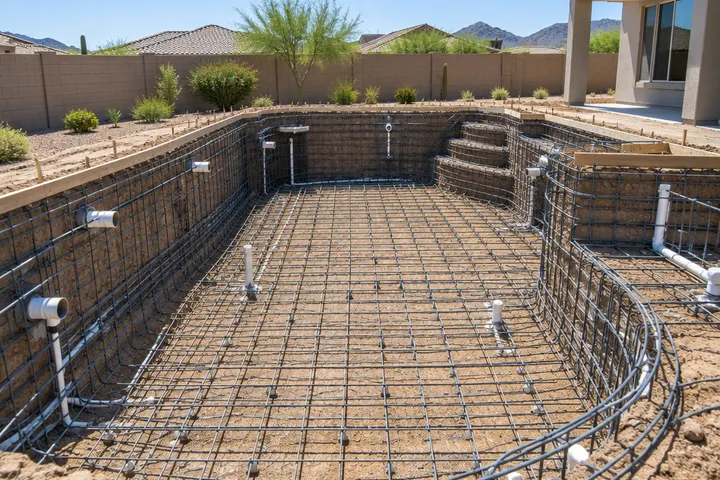

Rebar tied in a grid across the floor and walls, spaced to the engineered drawings.

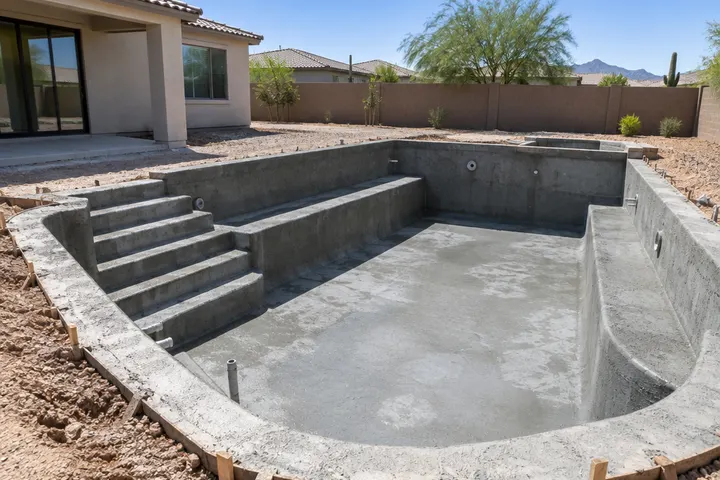

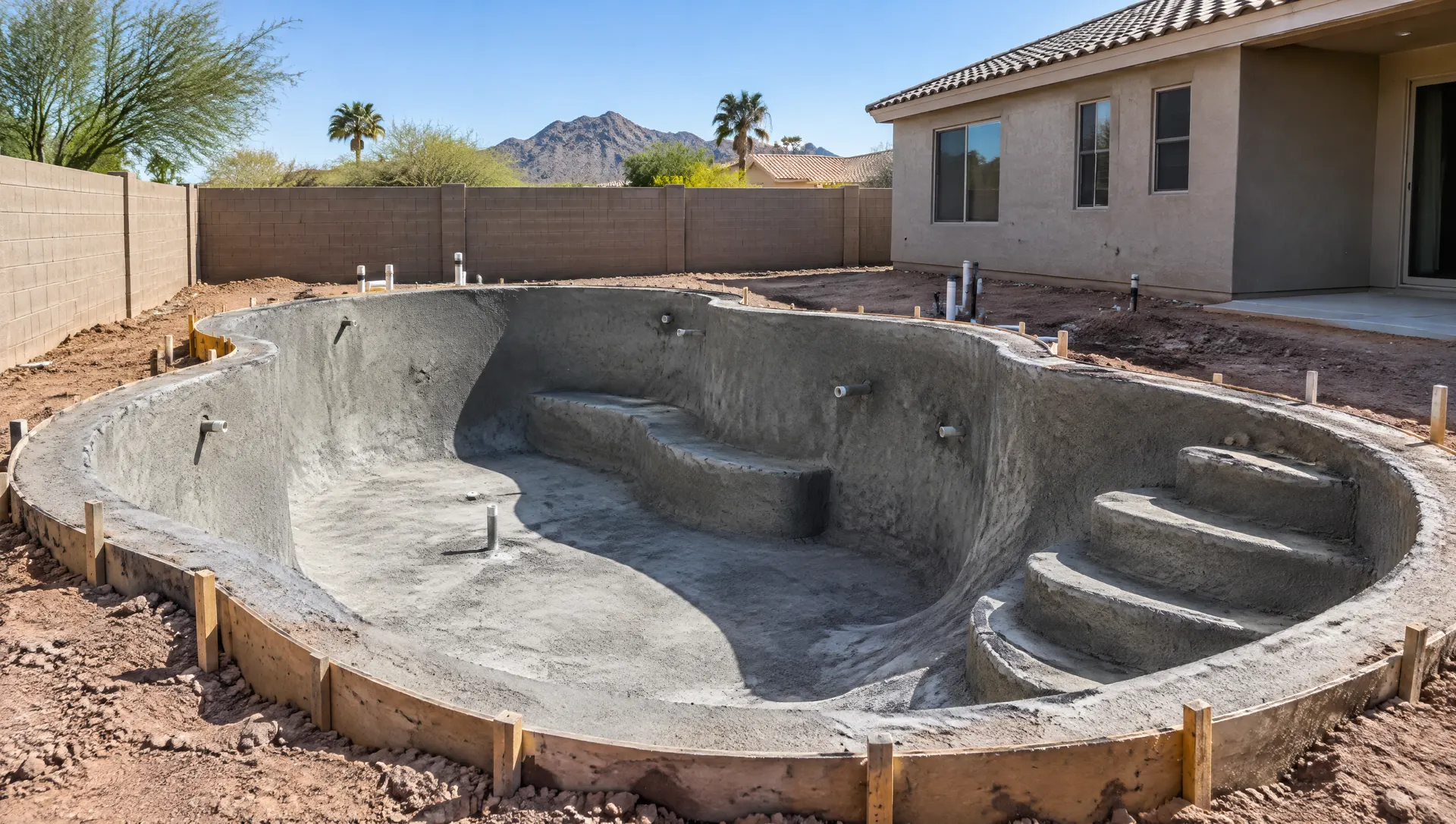

Concrete sprayed over the steel to form the shell, steps and benches, then cured.

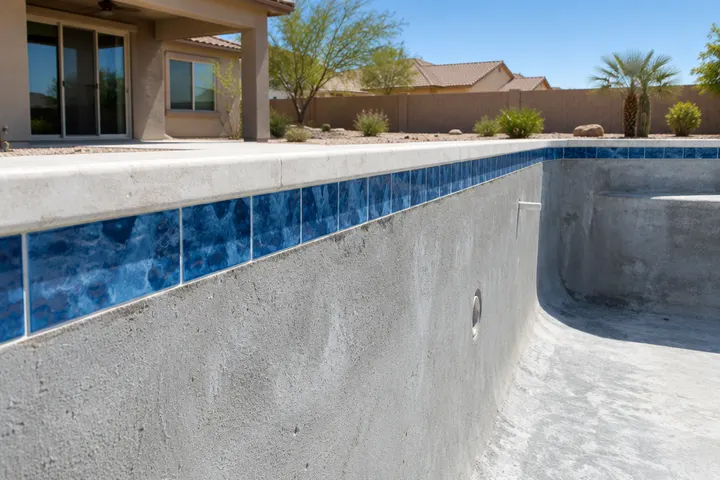

Waterline tile and coping set on the shell's top edge.

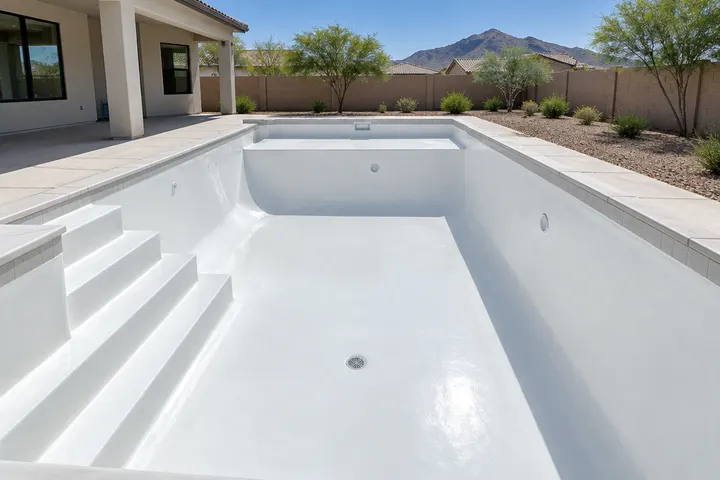

Plaster, quartz or pebble applied last, just before the fill.
| Phase | What happens | What you'll notice |
|---|---|---|
| Design | Yard measure, drawings, features and equipment chosen | Meetings and samples, no mess |
| Permit | Plans, engineering and contractor forms filed with the City of Mesa | Review time before the dig |

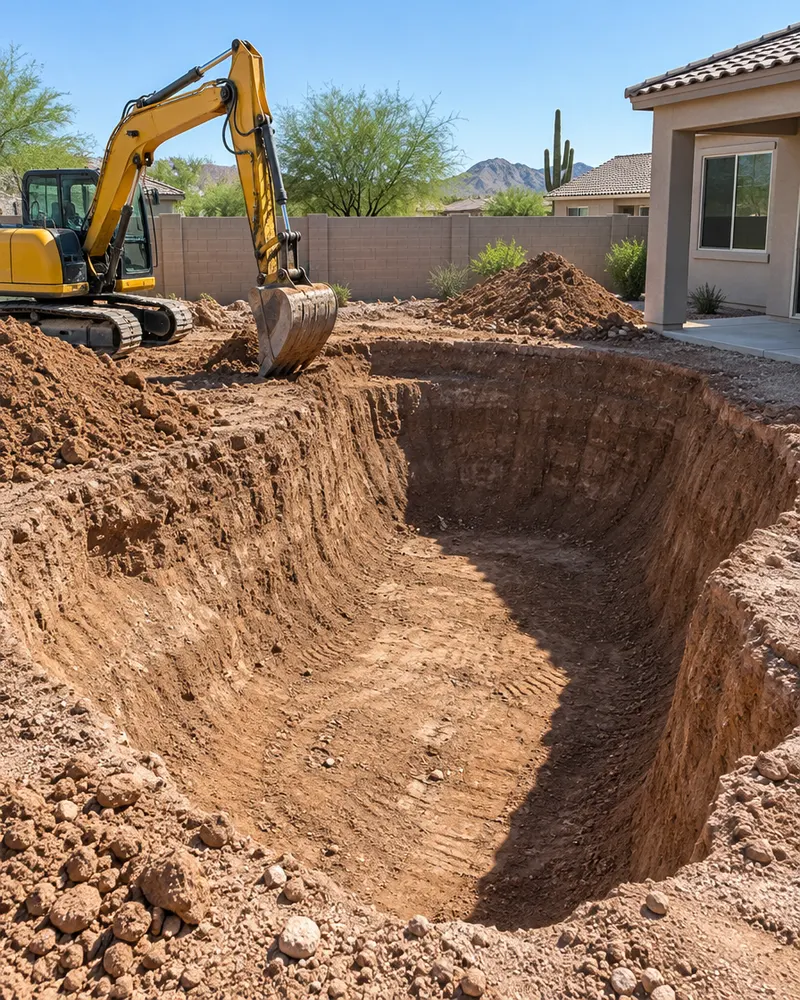

| Excavation | Layout painted, Arizona 811 locates, then the dig | A loud few days and a hole in the yard |
| Steel and plumbing | Rebar tied, pool lines run, City inspection | Inspector visits and an open shell |
| Gunite | Shell sprayed and cured | One busy day, then watering the shell |
| Tile, coping, deck | Waterline tile, coping, deck and electrical | The yard takes shape |
| Finish and fill | Interior finish applied, pool filled, water balanced | A hose running for hours |
A new inground pool in Mesa can't start without a City construction permit. The City's pool checklist asks for a Contractor Licensure Verification Form, a site plan with full dimensions, engineer-sealed structural drawings, and electrical, plumbing and mechanical plans. We prepare that package and file it through the City's online permit system.
Mesa's barrier brochure sets the numbers your new pool fence has to hit. No opening can pass a 4-inch sphere, and the barrier must sit at least 36 inches from anything permanent a child could climb, equipment included. Gate latches lower than 54 inches go on the pool side. We draw the fence, gates and equipment pad to those rules before the dig.
Design and City review usually take a few weeks. Construction from dig to fill commonly runs a couple of months for a standard pool, longer with a spa, large features or a full backyard package.
Several. Inspections happen at key stages such as steel and plumbing before gunite, electrical and bonding, and a final with the barrier in place. We schedule each one with the City of Mesa.
The access route takes the most wear. We protect it, and if a section of block wall has to come out for access, the proposal covers rebuilding it.
Once the interior finish is applied and the pool is filled, the water needs balancing for the new surface. We'll tell you when it's ready, usually within days of the fill.
